There's a number a lot of nonprofit fundraising pages love: a big, round figure — "$50,000 builds a school!" — that's easy to print on a banner and hard to actually verify. This article is the opposite of that. Part 4 of this series told the story of Orua Community Nursery and Primary School — a school parents built themselves, that nearly collapsed when payroll failed. This part answers the question every serious donor eventually asks: what does it actually cost to fix, and how do we know? The figures below come from one source: Patrick Kibwota's June 2026 site assessment, conducted after Amigos Internacionales was invited into Korobar. They are working estimates, not final audited numbers, and this article says so at every point where that distinction matters — because a transparent budget that admits its own limits is more trustworthy than a tidy one that doesn't.
New to this story? Part 4 tells how Orua Community Nursery and Primary School got here.
Repair, not rebuild — and why that matters financially
It's worth starting here, because it's the single biggest reason this budget looks the way it does. Amigos isn't proposing to build a new school in Korobar. The community already built one. What's being funded is repair, stabilization, and restored operations — a fundamentally different, and far less expensive, category of project than new construction.
The difference isn't small. According to Uganda's Business Times, citing the government's own 2025 Baseline Education Census, a single Ministry-of-Education-compliant classroom typically costs between UGX 30 million and 50 million to build new in Uganda — roughly $8,100 to $13,500 at recent exchange rates, for one classroom alone, before administration buildings, sanitation, fencing, or furnishing. A separate U.S.-based nonprofit's own published figures for a comparable new-construction primary school project in western Uganda — six classrooms, an administration building, a kitchen, a recreation field, latrines, and required faculty housing — came to $250,000 for the first construction phase alone.
Orua's entire facility-repair estimate — covering existing buildings, not new ones — is less than the cost of building a single new classroom from scratch.
Set against those national benchmarks, Orua's entire facility-repair estimate is $6,330 — for restoring existing buildings across the whole campus, not constructing a single new one. That's the financial case, in plain numbers, for why this series has been careful throughout to describe this project as restoration of something the community already built, not construction of something new.
The itemized budget
Here's exactly what Patrick Kibwota's June 2026 assessment identified, broken into the categories that actually determine whether this school reopens on schedule.

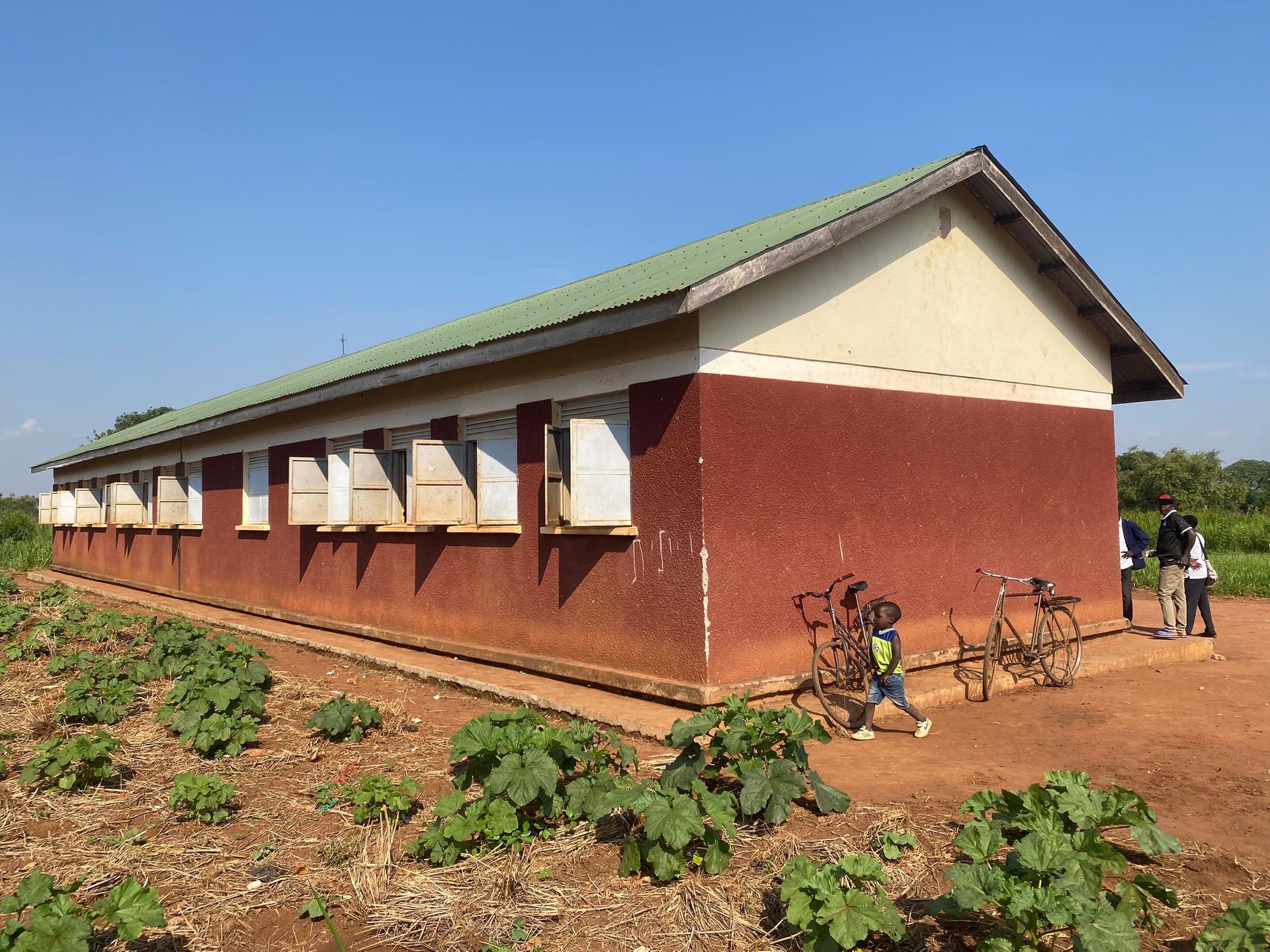

- Immediate facility repairs — approximately $6,330 Structural and finishing repairs to the existing four-room masonry classroom block and the two thatched classrooms — the kind of unglamorous work (roofing, flooring, walls, window fittings) that determines whether a building is usable in the rainy season, not just standing.
- Furniture and learning materials — approximately $2,557 Desks, benches, and basic teaching materials for classrooms currently under-equipped for the students expected to return once the preschool section reopens.
- Feeding-program startup — approximately $571 The smallest line item on this budget, and arguably one of the highest-leverage — in rural Ugandan schools, a feeding program is frequently the difference between a family sending a young child to school consistently or not at all.
- Teacher salary arrears — approximately $637 Back pay owed to teachers who kept showing up as long as they could before payroll collapsed. This is a debt, not a projection — it's owed regardless of what happens next.
Every number above is real. So is what your gift changes. $50 covers classroom supplies. $1,215 covers a month of restored payroll. $12,500 gets Orua Community Nursery and Primary School fully repaired, equipped, and stabilized.
Add those four together and you get the minimum immediate opening need: approximately $10,095. Amigos' practical fundraising target rounds that up to $12,500, building in a small, explicitly-labeled margin rather than fundraising to the exact minimum and hoping nothing goes over.
Beyond opening day: the six-month picture
A school that reopens and then runs out of operating money in October isn't actually restored — it's postponed. That's the thinking behind Amigos' six-month responsible launch range: $17,500 to $20,000, which adds several additional months of payroll, supervision, supplies, and contingency on top of the immediate opening need.
The ongoing, known recurring costs behind that range:
Monthly payroll — approximately $1,129 Monthly supervision and transportation — approximately $86 Known recurring monthly base — approximately $1,215
That last figure — $1,215 a month — is the number this series keeps coming back to, because it's the one that determines whether this school still exists a year from now, not just whether it reopens in January.
What isn't costed — and why that's disclosed, not hidden

Every serious nonprofit budget has a boundary between what's known and what isn't. Here's Orua's, stated plainly rather than glossed over:

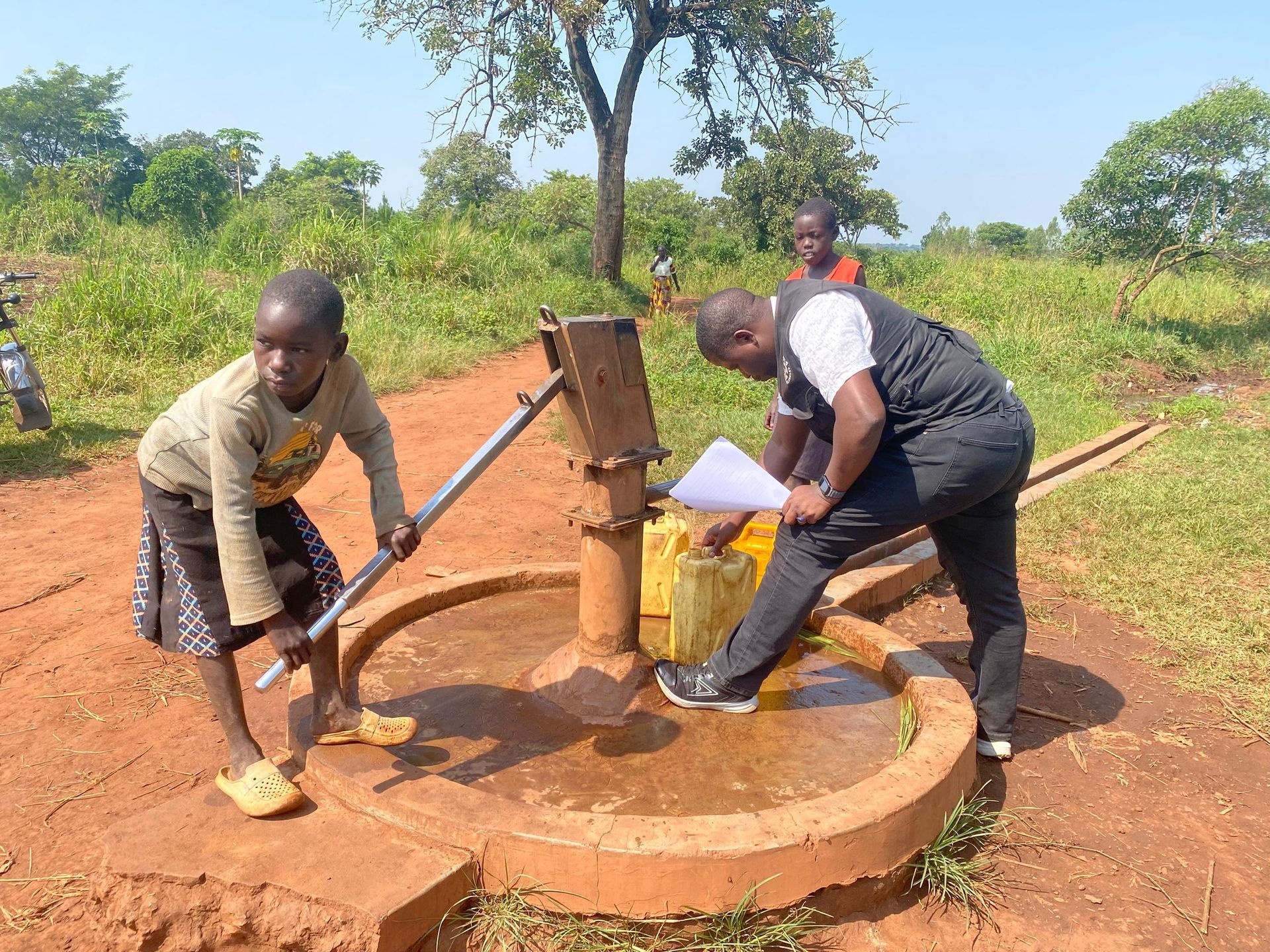

The deep well. The existing borehole on campus provides water, though not efficiently. Repairing it would meaningfully improve output, but it is not a blocking requirement for the school's reopening — which is exactly why it isn't folded into the $12,500 target above. No field quote for the repair exists yet. When one does, this article's numbers will be the ones to update, not the ones to quietly work around.
Final legal-transfer costs. The 10.396-acre land transfer itself was completed on July 9, 2026, but any residual administrative or legal costs tied to that process are not separately itemized here.
Exchange-rate movement. Every dollar figure above is a snapshot. Uganda's shilling moves against the dollar like any currency; a budget built in June 2026 will drift, in either direction, by the time funds are actually spent.
Final food and staffing costs. The feeding-program and payroll figures reflect June 2026 planning assumptions. Actual costs at the point of full reopening may differ.
None of this is a reason to distrust the numbers above it. It's the reason to trust them — a budget with no acknowledged uncertainty is usually one that hasn't been examined closely enough to find any.

How Amigos will report spending
This is the section every transparency-minded donor should be able to hold an organization to later. Amigos Internacionales' commitment for Korobar MissionPoint: funds raised against the $12,500 immediate target and the $17,500–$20,000 six-month range will be tracked against these same line items, with updates reflected in this series and on the Orua Community Nursery and Primary School project page as work is completed — not folded silently into general operating funds.
Ways to Give
- $50 — classroom and sanitation supplies
- $250 — contributes to repairs or learning materials
- $500 — helps equip a classroom $1,215 — approximately one month of known payroll and supervision
- $5,000 — funds a substantial portion of the transition
- $12,500 — the working target to repair, equip, and stabilize the school
- $17,500–$20,000 — the working range for a responsible six-month launch
Give to Korobar MissionPoint →
That's the transparent case, in full. What it can't fully convey — what a budget line never can — is what this school means to the people whose children walk onto that campus every morning it's open. Part 6 of this series explains how this single school fits into something larger: the full MissionPoint model Amigos is building around it.
FAQ SECTION
- How much does it cost to restore Orua Community Nursery and Primary School? The minimum immediate opening need is approximately $10,095, with a practical fundraising target of $12,500. A responsible six-month launch, including several months of ongoing operations, is estimated at $17,500 to $20,000. These are working estimates from a June 2026 site assessment, not final audited figures.
- Is this cheaper than building a new school? Significantly. A single new classroom in Uganda typically costs between UGX 30 million and 50 million (roughly $8,100–$13,500) to build to Ministry of Education standards, according to Uganda's Business Times, citing the government's 2025 Baseline Education Census. Orua's entire facility-repair budget — covering multiple existing buildings — is $6,330.
- What isn't included in this budget? The existing deep well's repair cost isn't included, since it's functional (though inefficient) and not a blocking need, and no field quote for the repair yet exists. Final legal-transfer administrative costs, exchange-rate movement, and final food/staffing costs at full reopening are also not locked in.
- How much does it cost to keep the school running each month? Known recurring monthly costs — payroll plus supervision and transportation — total approximately $1,215.
- How will Amigos report how donations are spent? Funds will be tracked against the specific line items in this article, with updates reflected in this series and on the Orua Community Nursery and Primary School project page as work is completed.
- Can I give toward a specific part of the budget? Yes, in the sense that giving levels ($50, $250, $500, etc.) are tied to categories described in this article. Confirm with Amigos directly whether your gift can be formally restricted/coded to a specific line item if that matters to you.
Coming Soon Part 6: More Than a School — how this budget fits into the full Korobar MissionPoint model.
